Glazing Scope Gaps That Blow Up Commercial Schedules

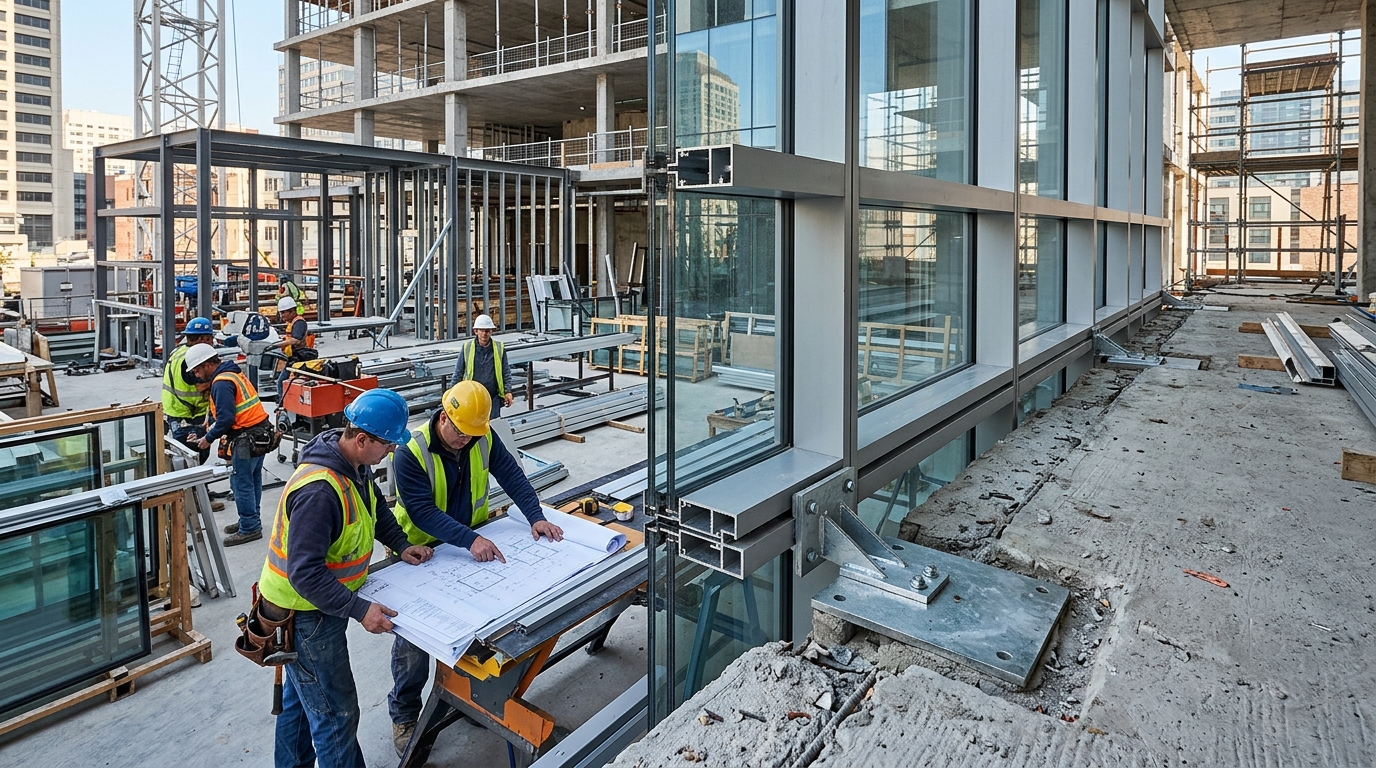

Most commercial schedule slips blamed on "glass being late" are actually scope gaps, work that nobody clearly owned at bid time, discovered weeks before the glazier mobilizes. The four that hurt most: perimeter sealant and backer rod, blocking and embeds in the rough opening, who furnishes the structural-silicone-glazed (SSG) test program, and IGU lead times that were never confirmed against the actual Low-E coating specified. Close these before award and the curtain wall installs on the dates on your wall.
The Scope Line Everyone Assumes Belongs to Someone Else

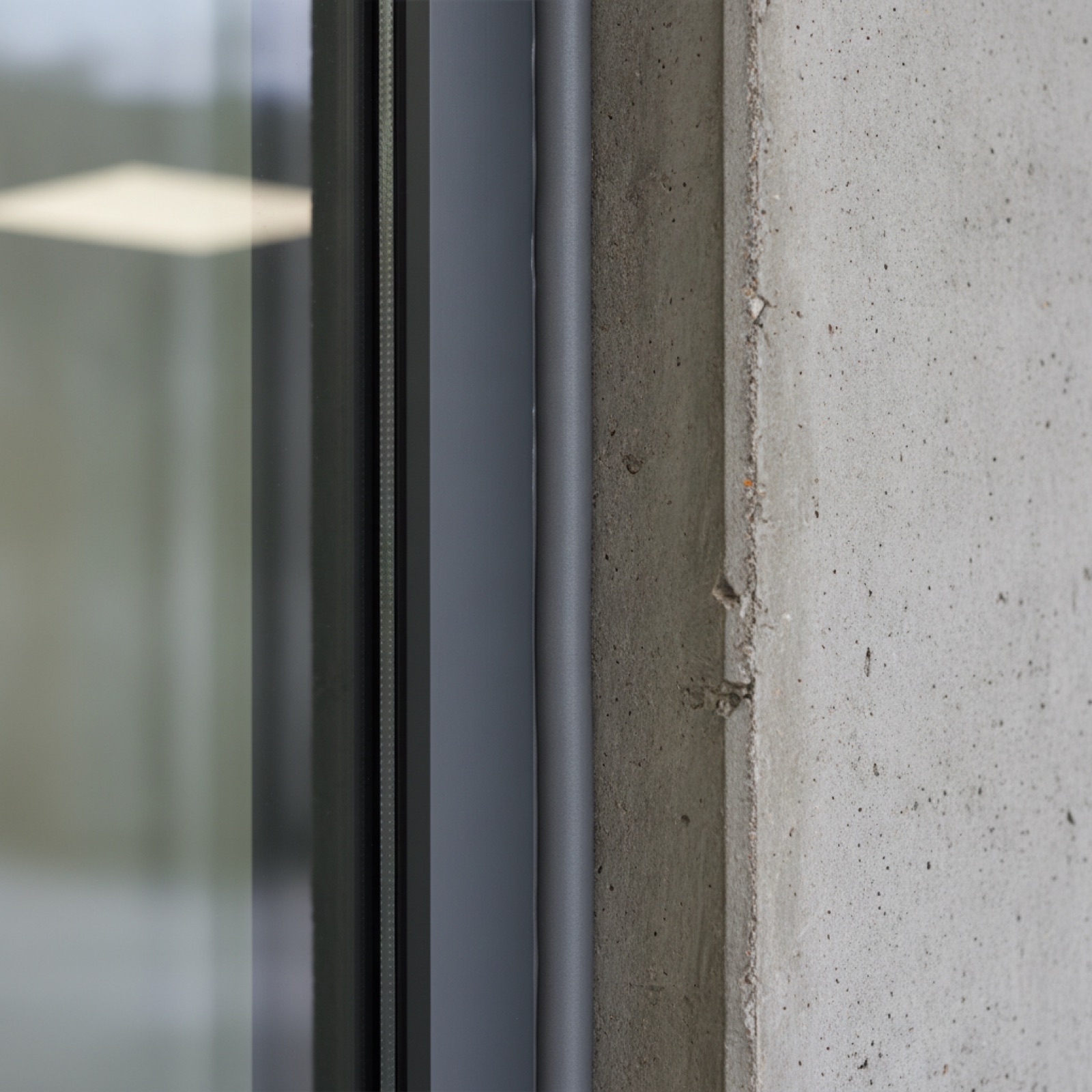

The perimeter is where glazing scope goes to die. The aluminum framing is clearly the glazier's; the wall is clearly the framer's; the joint between them, backer rod, perimeter sealant, fire-safing at the slab edge, is the gap. When it isn't drawn into a trade, it shows up as a change order and a two-week stall while everyone re-prices it. The same happens with embeds: storefront and curtain wall anchor to steel or cast-in embeds that the concrete/steel trade had to place to tolerance before the glazier ever arrives. Miss the embed coordination and you're field-welding clip angles, which nobody scheduled.

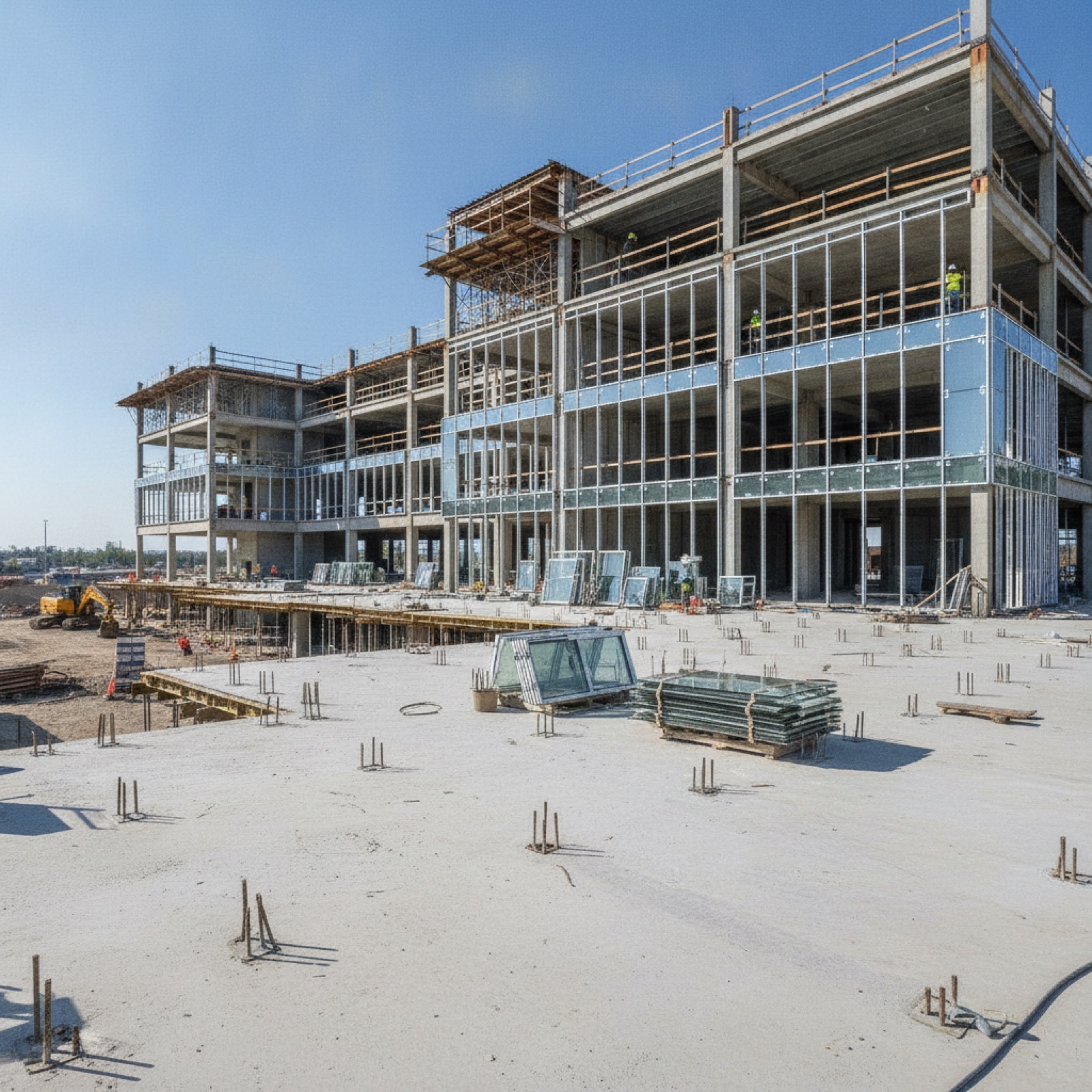

Scope Gaps Ranked by Schedule Damage

| Scope gap | Who usually owns it | Why it slips | Schedule hit |
|---|---|---|---|
| Perimeter sealant / backer rod | Often unassigned | Falls between framer and glazier | 1–2 wks |
| Cast-in embeds / blocking | Concrete or steel, set early | Tolerance + timing missed | 2–4 wks |
| SSG test / mockup program (AAMA 501) | Owner vs. glazier ambiguity | Not budgeted at bid | 3–6 wks |
| IGU lead time vs. specified Low-E | Glazier, but spec-driven | Custom coating/size not verified | 6–12 wks |
| Spandrel / shadow-box backpan | Glazier vs. insulation trade | Assembly ownership unclear | 1–3 wks |
Long-Lead Items Hide Inside the Spec

The most expensive gap is the one that looks closed. A storefront system is stock; a unitized curtain wall with a custom Low-E coating, oversized lites, or a non-standard finish is not. Lead time is set by the least available component, frequently the IGU. Confirm the actual glass make-up against the architect's spec at buyout, not at submittal, because a coating swap or a lite over the fabricator's standard size can move delivery by months. Stick-built systems give you scheduling flexibility on site; unitized systems front-load the schedule into the shop, so a shop delay is a site delay with no recovery.
How Ramos Closes the Gaps Before Mobilization

We write detailed, scoped submittals that name every line, perimeter sealant, embeds, blocking, mockup responsibility, so nothing rides on assumption. Our installers are W-2, not a rotating sub crew, so coordination commitments made at buyout are the same people on site. Licensed in California (C-17 #1034872) and Arizona (ROC #343677) and glazing across SoCal and the Phoenix metro since 1987, we've seen where these gaps open and we flag them in the bid, not in an RFI three weeks before glaze.
Get Ahead of the Gap

Bring us in at buyout and we'll mark the perimeter, embed, and long-lead exposures in writing before they become change orders. Request a Glazing Bid or grab the free Commercial Glazing Spec Kit to pressure-test your next package before it goes out.
Frequently Asked Questions
Who is responsible for perimeter sealant on a curtain wall?
It varies by contract, which is exactly why it slips. The glazier furnishes the framing and glass; the perimeter joint between framing and the adjacent wall must be explicitly assigned in the scope. If your specs don't name it, assign it at buyout to avoid a change order.
What's the single longest-lead glazing item on a commercial job?
Usually the insulated glass unit (IGU), especially with a custom Low-E coating or an oversized lite. Verify the actual glass make-up against the architect's spec at buyout, not at submittal, because a coating or size outside the fabricator's standard can add weeks to months.
Should we use stick-built or unitized curtain wall to protect the schedule?
Unitized front-loads fabrication into the shop and installs fast on site, but a shop delay is unrecoverable. Stick-built is more forgiving to field sequencing but slower to hang. The right choice depends on whether your critical path is the shop or the site.
Related Articles

How to Prequalify a Glazing Subcontractor
A GC's checklist to prequalify a commercial glazing sub: license, insurance, W-2 crews, system experience, AAMA/ASTM test track record, and warranty.

Aluminum Storefront Systems Compared (Center-Set, Offset, Flush)
Center-set vs. offset vs. flush aluminum storefront, glazing plane, sightlines, water management, and where each system fits. Spec guidance for GCs.

Spandrel Glass and Aluminum Composite (ACM) Panel Integration
How spandrel glass and ACM panels integrate in curtain wall and storefront facades, back-pan vs. opacified options, thermal, fire, and spec guidance.
We use cookies and similar technologies to improve your experience on our website.
